Contents
1.1 Purpose of the Report
1.2 Structure of the
Report
2.1 Background
2.2 Works Programme and
Works Locations
2.3 Construction
Activities
2.4 Status of
Environmental Approval Documents
3.1 Cable Installation
Water Quality Monitoring
3.2 Marine Mammal
Observation (MMO)
3.3 Coral Monitoring
3.4 Site Inspection and
Audit
5 Environmental
Non-Conformance
5.1 Summary of
Environmental Non-compliance
5.2 Summary of
Environmental Complaint
5.3 Summary of Environmental
Summon and successful prosecution
6.1 Key
Issues for the Next Reporting Period
6.2 Monitoring Schedule
for the Next Reporting Period
LIST OF TABLES
Table 2.1 Summary
of Current Environmental Licensing, Notification and Permit Status
Table 6.1 Construction
Works to Be Taken For the Next Reporting Period
LIST OF ANNEXES
Annex A Proposed
ASE Submarine Cable System (Layout Plan)
Annex B Location
of ASE Landing Point and Terrestrial Cable Route
Annex C Completed
Site Inspection Log
Annex D Photographic
Records on Site
EXECUTIVE SUMMARY
NTT Com Asia
(NTTCA) proposes to install a telecommunication cable (Asia Submarine-cable
Express (ASE) cable) of approximately 7,200 km in length, connecting Japan and
Singapore with branches to the Philippines, Hong Kong SAR (HKSAR) and
Malaysia. A Project Profile
(PP-452/2011) which includes an assessment of the potential environmental
impacts associated with the installation of the submarine telecommunications
cable system was prepared and submitted to the Environmental Protection
Department (EPD) under section 5.(1)(b) and 5.(11) of
the Environmental Impact Assessment Ordinance (EIAO) for the application for
Permission to apply directly for Environmental Permit (EP). The Environmental Protection Department,
subsequently issued an Environmental Permit (EP- 433/2011).
This is the Thirteenth Weekly Site Inspection Report that presents the
findings of the site inspection and other EM&A activities
undertaken during the period from 22 February 2013
to 28 February 2013.
Environmental Site Inspection
A weekly environmental site inspection
was carried out by the representative of the Environmental Team (ET). Environmental performance complied with
the environmental requirements and all necessary mitigation measures were
properly implemented.
Environmental Complaints,
Non-compliance & Summons
No non-compliance with PP
recommendations, EP conditions and other requirements associated with the
construction of the Project was recorded in the reporting period.
No environmental complaint was
received in this reporting period.
No environmental summons
was received in this reporting period.
Upcoming Works for the Next
Reporting Period
The remaining works at the cable
landing point are the construction of protection fences for the new beach
manholes. Potential environmental
impacts arising from these
activities are mainly associated with dust and waste management.
ERM-Hong Kong, Limited
(ERM) was appointed by NTT Com Asia (NTTCA) as the Environmental Team to conduct
regular site inspections and audit the implementation of all environmental
monitoring and mitigation measures recommended in the Project Profile (PP) (Register
No. PP ¡V 452/2011) for the Proposed Asia Submarine-cable
Express (ASE) ¡V Tseung Kwan O (the Project).
This is the Thirteenth Weekly Site Inspection Report
(the Report), which summarises the inspection findings for the period from 22
February 2013
to 28 February
2013 and
the implementation status of the EM&A recommendations on environmental
protection and pollution control mitigation measures and monitoring.
The structure of the Report
is as follows:
Section 1
: Introduction
Details the scope and structure of the
Report.
Section 2 : Project
Information
Summarises background and scope of the Project, site
description, construction programme, the construction works undertaken and the
status of Environmental Permits/Licenses during the reporting period.
Section 3 : Environmental
Monitoring
Summarises
the monitoring programmes as recommended in the PP and the monitoring undertaken
during the reporting period.
Section 4 : Site Inspection Results
Summarises the findings of the weekly
site inspection undertaken within the reporting period.
Section 5 : Environmental Non-conformance
Summarises any exceedances of
environmental performance standard, environmental complaints and environmental
summons received within the reporting period.
Section 6 : Upcoming
Works for the Next Reporting Period
Summarises the impact
forecast and monitoring schedule for the next reporting week.
Section 7 : Conclusions
NTT
Com Asia (NTTCA) proposes to install a telecommunication cable (Asia
Submarine-cable Express (ASE) cable) of approximately 7,200 km in length,
connecting Japan and Singapore with branches to the Philippines, Hong Kong SAR
(HKSAR) and Malaysia. NTTCA is
responsible for securing the approval to land the ASE cable in Tseung Kwan O,
Hong Kong SAR (HKSAR). The proposed
landing site will be at a new Beach Manhole (BMH) and ultimately connect with a
Data Centre in Tseung Kwan O (TKO) Industrial Estate which is scheduled for
completion in 2012. From Tseung
Kwan O, the cable will extend eastward approaching the Tathong Channel. Near to Cape Collinson, the cable is
approximately parallel to the Tathong Channel until north of Waglan Island where
the cable travels eastward to the boundary of HKSAR waters where it enters the
South China Sea. The total length
of cable in Hong Kong SAR waters is approximately 33.5 km. A map of the proposed cable route is
presented in Annex A.
A
Project Profile (PP-452/2011) which includes an assessment of the potential
environmental impacts associated with the installation of the submarine
telecommunications cable system was prepared and submitted to the Environmental
Protection Department (EPD) under section 5.(1)(b) and
5.(11) of the Environmental Impact Assessment Ordinance (EIAO) for the
application for Permission to apply directly for Environmental Permit
(EP). The Environmental Protection
Department, subsequently issued an Environmental Permit (EP-
433/2011).
Under the requirements of Condition
2.4 of the EP, an EM&A programme as set out in the revised Environmental
Monitoring and Audit Manual (EM&A Manual) is required to be
implemented. The EM&A programme
includes water quality monitoring, marine mammal observation, coral monitoring
and weekly site inspection.
The location of the cable
installation works within the boundary of Hong Kong SAR waters is shown in Annex A, while the location of the landing point (ie
new Beach Manhole (BMH) in TKO Industrial Estate) is shown in Annex B.
Submarine
Cable Installation
Starting
from 8 October 2012, the submarine-cable laying works in Zone A, Zone B and
Zone C have been largely finished and the installation barge reached the
boundary of Hong Kong marine waters on 24 October 2012. All marine works associated with the
Project were finished in late January 2013.
Landing
Point Construction
The
construction works of the landing point, which included the beach manholes and
the land duct, commenced on 4 October 2012, and were completed in late December
of 2012. During the reporting
period, dismantlement of the site hoarding fences were conducted at the landing point on 22 ¡V 26 February
2013.
A summary of the relevant
permits, licences, and/or notifications on environmental protection for this
Project is presented in Table 2.1.
Table 2.1 Summary
of Current Environmental Licensing, Notification and Permit Status
Permit/ Licences/
Notification |
Reference |
Validity Period |
Remarks |
Environmental
Permit |
EP-433/2011 |
Throughout
the construction and operation of the Project |
Permit
granted on 20 December 2011 |
Construction
Noise Permit |
GW-RE0774-12 |
18 Sep 2012 ¡V 31 Jan 2013 |
Permits
granted on using of registered powered mechanical equipment for 07:00-23:00
hrs on general holidays (including Sundays) and 19:00-23:00 hrs on any day
not being a general holiday for Sub-marine cable laying works of the Project |
Baseline
water quality monitoring was completed by the end of September 2012. Baseline Water Quality Monitoring
Reports for Zone A, Zone B and Zone C were submitted on 19 September 2012, 25
September 2012 and 1 October 2012, respectively.
Daily
impact water quality monitoring was conducted in the reporting period as all jetting
works associated with the Project were completed on 29 December 2012.
As all marine works
of the Protect were finished in late January 2013, post project water quality
monitoring in Zone A, Zone B and Zone C was conducted in
February 2013. Post Project Water
Quality Monitoring Reporting summarizing the findings of the water quality
monitoring in the three zones were submitted on 28 February 2013.
Daily
marine mammal exclusion zone monitoring is required to be conducted during the
cable installation works taking place in daylight hours along the sections
outside Zone A to Zone B (ie Zone C and from C to the boundary of HKSAR
waters). This monitoring was not
carried out in the reporting period as the cable installation works in Zone C
and from C to the boundary of HKSAR waters were completed on 24 October 2012.
Baseline
coral monitoring was completed in September 2012. The Baseline Coral Monitoring Survey
Report was submitted on 28 September 2012. Impact monitoring for coral during cable
installation works is not required under the Project.
In
the week of 8 October 2012 when the cable installation barge passed the
identified coral communities as presented in the Baseline Coral Monitoring Survey Report, the nearest distances
between the barge and the identified coral communities in Zone A and Zone B
were 230m and 270m respectively, indicating the cable alignment of more than 180m
away from the identified coral communities as required in the Environmental
Permit (EP- 433/2011).
Post-project
coral monitoring was conducted within one month after completion of the marine
works of the Project in late January.
The Post-Project Coral Monitoring Survey Report was submitted to EPD and
AFCD on 28 February 2013.
In
accordance with the revised EM&A Manual, a weekly site inspection should be
undertaken at the landing point (ie new Beach Manhole (BMH) in TKO Industrial
Estate) to ensure that the appropriate environmental protection and pollution
control mitigation measures are properly implemented in accordance with the
Project Profile (PP-452/2011). Results
of the site inspection in the reporting period are provided in Section 4.
The weekly site inspection is
required to be carried out by the representative of Environmental Team (ET). A Site Inspection Log is
completed by the ET representative to record whether the Contractor is
compliant with environmental regulations in terms of noise, water quality and
housekeeping etc (Annex C).
During the reporting
period, the site inspection was conducted on 28
February 2013. Construction works for both the new beach manhole and land duct at the cable landing point have been
largely completed. The site hording
fences for both the new beach manholes area and the land duct area have been
dismantled (Annex D Photos Nos. 1 and 2).
Areas within and in vicinity of the construction site have been
reinstated to their original status (Annex D Photos Nos. 3 and 4).
There was no non-compliance recorded
during the site audit.
No
non-compliance of PP/ EM&A/ EP/ legislative requirements was recorded
during the reporting period.
No
complaint was received during the reporting
period.
No
summons was received during the reporting period.
Works to be taken for
the next reporting period are summarised in Table 6.1.
Table
6.1 Construction
Works to Be Taken For
the Next Reporting Period
Work to be taken |
¡P
Construction of
the New Beach Manhole Fence |
Potential environmental impacts arising from the above
activities are mainly associated with dust and waste management.
Next weekly site inspection
will be conducted in the week when the construction of the new beach manhole fence
is carried out.

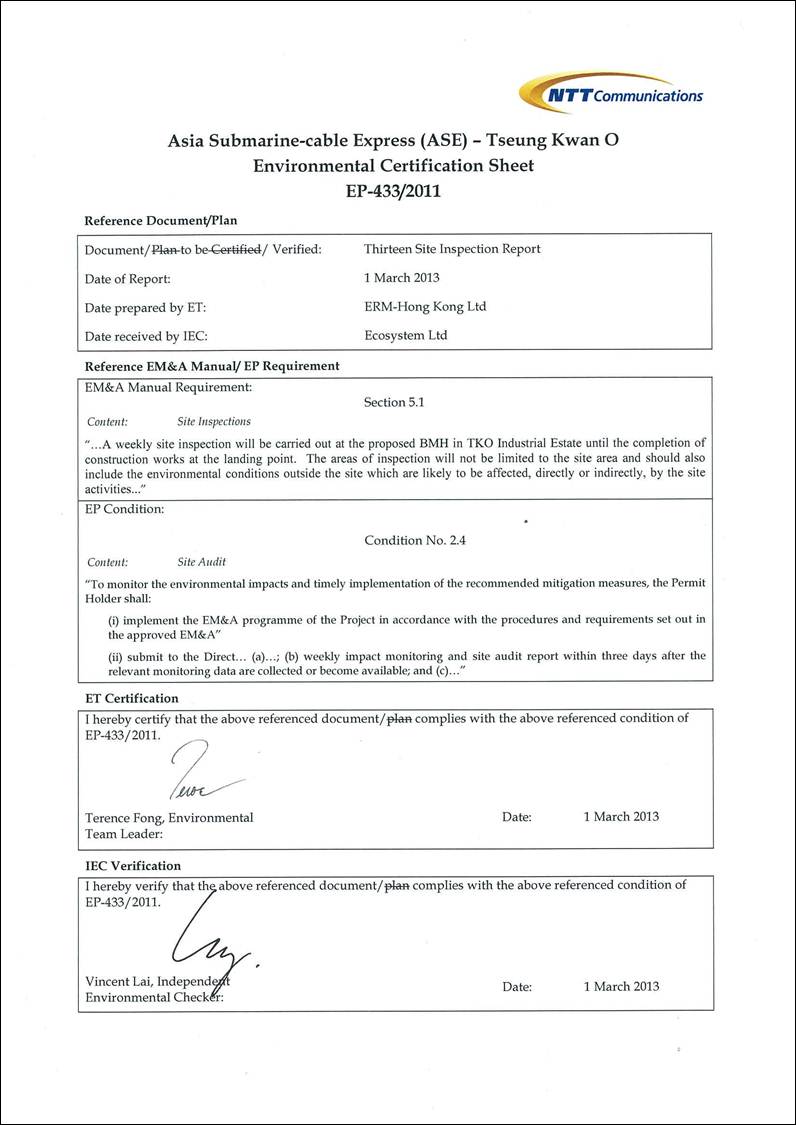

This Thirteenth Weekly Site Inspection Report presents the findings of
the site inspection and other EM&A activities
undertaken during the period from 22 February
2013 to 28
February 2013,
in accordance with the PP (Register No. PP ¡V 452/2011), revised
EM&A Manual and the requirements of Environmental Permit (EP- 433/2011).
No
impact water quality monitoring was carried out in the reporting week and
neither was the daily marine mammal exclusion zone monitoring, as all marine
works associated with the Project were completed in late January 2013.
A weekly environmental site
inspection was conducted on 28 February 2013
during the reporting period. It
confirmed that the environmental mitigation measures recommended in the PP were
properly implemented by the Contractor.
No
non-compliance event was recorded during the reporting period.
No complaint and
summons/prosecution was received during the reporting period.
The ET will keep track on
the construction works to confirm compliance of environmental requirements and
the proper implementation of all necessary mitigation measures.
